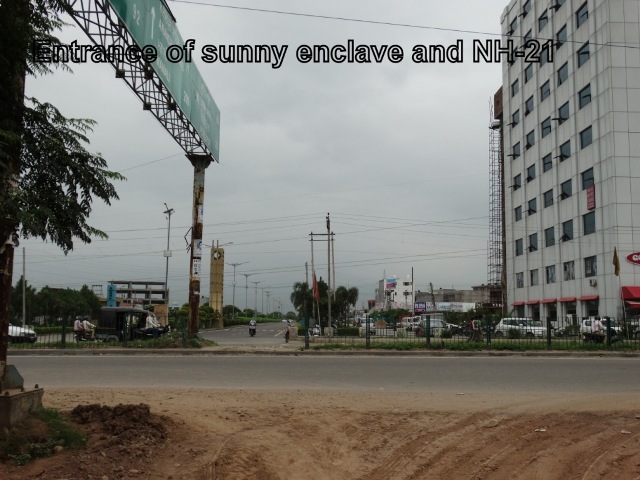

KHARAR (GREATER MOHALI)

It is located on NH-21 and is about 15 Kms from Chandigarh Airport and 18 Km from Chandigarh Railway Station.
Update : (28 Jul 14)
  • Updates on Meter Installation, Energization of 66 KV Sub-station and SUB-LETTING DUs (8 Jul 14)... [Read more....]
  • Updates dated 14 Jun 14... [Read more....]
  • Handing over of Dwelling Units. (26 May 14). [read more...]
  • Tentative Schedule for Handing Over (20 May 14). read more...
  • Status of Energisation of 66 KV Substation (07 May 14). read more...
  • Road map for completion of Balance works (02 May 14). read more...
  • The Handing/Taking over schedule of Dwelling Units. (16 Apr 14).... read more...
    UPDATE ON AUDIT OF TILE - AFNHB GREATER MOHALI (KHARAR) PROJECT (28 Feb 14)
    1. Consequent to the visit of DG, AFNHB and Principal Director (Wks) to the project on 01 & 02 Feb 14, a technical audit with the members from AFNHB, Project Staff, Contractor and tile manufacture was carried out from 04 Feb 14 to 16 Feb 14. The aim of the audit was to ascertain the requirement and identify the flats which have shade variation on the floor tiles. The team visited each and every flat except those found locked (Handed Over) in the 18 towers which have been offered to the allottees for taking over.
    2. The comprehensive audit report has then been compiled and the total quantity of tile requirement ascertained. The required quantity has been intimated to the tile manufacturer i.e. M/s. Somany Tiles.
    3. M/s. Somany has been instructed to carry out a thorough check of all its stocks which were supplied with similar shades, during the corresponding period when the tiles were supplied to Mohali project. Although few boxes have been located at Ahmadabad, these are very less compared to our requirement. M/s. Somany has sought one weeks’ time i.e. upto 04 Mar 14 to carryout full search on all over India basis with their stockiest to locate similar shade tiles if available. Based on the total tiles located, these would then be brought to the Mohali Project and replacement in those flats where shade variations exists will be under taken. At the same time allottees are at liberty to locate matching tiles from the market (including other manufactures) and the tiles will be replaced.
    4. Next update would be posted after 07 Mar 14 to appraise the status.
  • Registration Of DUs-Execution Of Conveyance Deeds (24 Feb 14).... read more...
  • Our first resident of Greater mohali Project Cdr Satwinder Singh (Retd.) has shifted to his DU on 12 Feb 2014 in tower B-802. All the essential facilities like electricity, water, lifts, sewerage etc. are operational and are functioning satisfactorily.
  • Provision of Portable Gen Sets (05 Feb 14).... read more...
  • Update – Electric Metering and Load Sanctioned 05 Feb 14).... read more...
  • Addition/Alteration to Flats and Electric Connection (24 Jan 14).... read more...
  • Sitrep-Fitment Of Electric Meters (24 Jan 14).... read more...
  • Sitrep-Status For Lift Work (24 Jan 14).... read more...
  • Update on Energisation (Last update as on 20 Dec 13). read more...
  • Equalization Charges:It is informed the equalization charges in the project are charged from late joiners/ defaulters as per the rates prescribed in the Master Brochure and Allotment Letter. To bring the parity among the allottees such charges, so collected, are ploughed back to the project for common benefit of all the allottees. In this project the equalization charges were freezed on 08 Jan 12 means no charges will be charged from the allottees who delay the payments beyond this frozen date. Similarly, no equalization charges shall be charged from the allottees on the interim installment as called on 29 Apr/02 Jul 13.
  • SERVICE PROVIDER – ELECTRIC METER (as on 07 Dec 13). read more...
  • Brief Project Energisation (02 Sep 13). read more...
  • Handing over of Towers (30 Aug 13). read more...
  • News Paper Articles as on 28 Jul 13. read more...
  • Handing over schedule for Blocks. N,X,M,G,F,E and D.(01 Jul 13) read more...
  • Interim Installment Kharar Update on 24 Jun 13. read more ...
  • Electrical fittings required for each category of flats. (31 Jul 13) . read more ...
  • General information for all allottees. (as on 01 Aug 13) . read more ...
  • Electrical fittings required for each category of flats. (31 Jul 13) . read more ...
  • Before taking Handing over of Dwelling Units (10 Jun 13) . read more ...
  • Greater Mohali:Sitrep on Energization of The Project. read more ...
  • Interim instalment(26-Apr-2013). read more ...
  • Handing Over schedule of S Block re-scheduled to commence from 06 May 2013 due to technical snag in the water distribution system from overhead tank to DUs leading to seepage at certain places.
  • A number of allottees of Greater Mohali Scheme, who have taken House Building Loan from Air Force Group Insurance Society, have approached this Board to take up a case for timely payment of the interim installment due on 29 Apr 13. Based on their request, a case is being taken up with AFGIS. Further communication to the affected allottees shall follow in due course of time.
  • Letter to all Allottees (INTERIM INSTALLMENT) dated : 12 Apr 13. more...
  • HANDING OVER OF GREATER MOHALI PROJECT (12 Apr 13) .... more

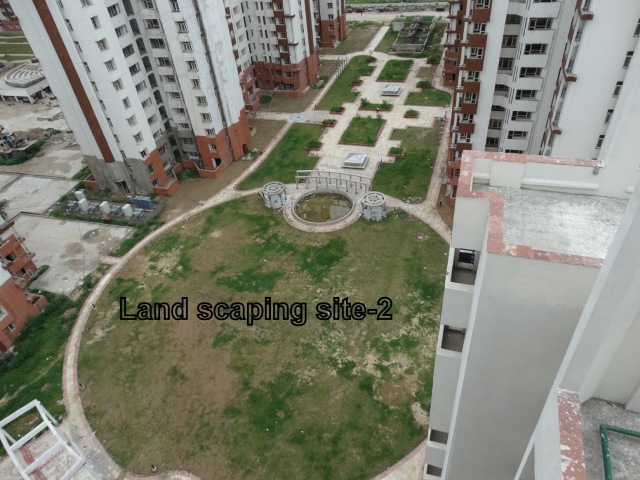

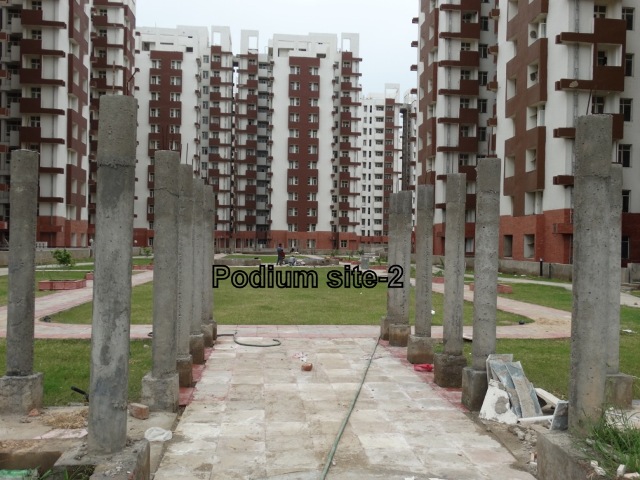

  • The Gr Mohali project is in its final leg of completion. The end activities, such as land scapping, construction of main gate, clock tower etc is in progress (photographs enclosed). The intended target is to complete the project in by Oct (including land scapping) AFNHB Gr (Mohali) is a prestigious project for the Board and its success will give us encouragement to undertake projects of this magnitude in future, needless to say all the activities are being closely monitored.
  • Till date approx 550 DUs have been offered for taking over (All categories) and 53 DUs have been taken over. We have received a very positive and encouraging response. Some of the comments have been attached for your preview. ... more
  • STATUS OF EXTERNAL ELECTRICITY SUPPLY : The correspondence regarding laying of 66 KVA HT line from 220 KV Station, Kharar to 66 KVA Station at Sunny Enclave. For more details please click here.
  • Gp Capt Anil Singha, Project Director, Greater Mohali has been posted out from AFNHB w.e.f. 01 Apr 13. Kindly correspond with Cdr SS Saini email Id: sarvis@rediffmail.com and mobile No. 09216878929.
  • All allottees are informed that the interim installment called on 29 Apr 13 is towards the part of final installment called earlier. There is no further escalation/increase in the cost as intimated in the allottees meeting at site on 15 Nov 11. The project expenditure are being incurred whereas the receipts from the allottees are yet to be received. A few of the allottees approached to this Board to accept the part of the installment now and balance at the time of possession of Dwelling Unit. The request of the allottees has been considered favorably and also in order to meet the expenditure and to ease out the final burden on the allottees, this interim installment is called. All allottees are requested to remit this interim installment latest by 29 Apr 13, failing which equalization charges as per policy, shall be charged.
  • Interim instalment due on 29 Apr 13. read more ...
  • Handing/Taking over schedule for I, H, C, R and S block (6 Mar 13). read more ...
  • Notice : A Team from AFNHB HQ visited Greater Mohali Project Site for issue of clearance and Possession letter between 04-07 Feb 2013.
  • Handing over schedule for A, B, T, U and V block (07 Dec 2012) More....
  • All allottees of Gr. Mohali are informed that the Possession of Dwelling Units at Project site has been commenced from 17 Dec 12 onwards for A, B, T, U, V and W block as per schedule given to the allottees. Allottees are requested to collect Possession letter from AFNHB, Delhi office, if not taken earlier, prior to the handing/ taking over of possession of DU at site. It is also informed that the last installment, as intimated earlier, can be paid either by cheque or demand draft or ICICI Bank Challan. It is to be ensured that the last installment is paid and credited to AFNHB Bank account if paid by cheque/ICICI Bank Challan prior to approaching AFNHB for possession letter. For this purpose the copy of Bank Account statement/Pass book is to be given at the time of collection of possession letter, through which the payment(s) is/are made by the allottee.
    STATUS:
  • Status of External Electric Supply 04 Apr 13). read more ...
  • Status of Handing over of flats and facilities available (08 Jan 13). read more ...
  • All Flats of A,B,T,U,V and W Blocks are ready for possession (20 Nov 12). read more ...
  • Greater Mohali (Kharar) : Updates (25 May 12)
  • Greater Mohali (Kharar):NOTICE:Handing over of Dwelling Units (02 Mar 12)
  • Handing over of dwelling Units : Letter dated 17 Feb 12.
  • All allottees are requested to deposit Rs.6000 towards Society Charges which is tentatively fixed at Rs.1000 per month per allottee. The amt. is to be paid along with other dues while collecting Possession Letter.(30 Dec 11)
  • All allottees are requested to communicate their telephone number and e-mail address to the President of the Society at jvtmohali@gmail.com, jvt-mohali@googlegroups.com(30 Dec 11)
  • Issue of Possession Letter:Letter dated 12 Dec 11.
  • Handing over schedule of two specific blocks for Greater Mohali (Kharar) is planned in the month of Jan 2012 followed by other blocks as per schedule of HO for Physical possession received from Project Office. Contact Wg Cdr Anil Singha on 09216999342 and Cdr SS Saini on 09216878929.(12 Dec 11)
  • Inauguration
    The AFNHB Greater Mohali scheme was inaugurated by Air Mshl J N Burma PVSM AVSM VSM, AOA & Chairman AFNHB on 15 Nov 11 at 1100hrs. He was accompanied by R Adm R Gaikwad NM, Director General AFNHB. Approx. 350 allottees were present during the function including serving and retired Naval/Air Force Officers. The AOA visited the sample flats and had tea with the allottees. Thereafter, the Final Costing presentation was given by the DG AFNHB to the Allottees and finally the meeting concluded with vote of thanks.

    FACILITIES PLANNED:
    Parking in basement, Stilts, Podium and open. Two Community Centers. Two Swimming Pools. Jogging track and landscaping over basement and stilt roofs etc. Power backup for emergency services.
    TYPE
    SUPER AREA (APPROX) IN SQ FT
    NO OF DU
    TENTATIVE COST (RS.IN LAKH)
    ACCOMODATION
    OFFICERS
    AI
    1970
    247
    34.48
    DRAWING/DINING, THREE BEDROOMS, ONE SERVANT ROOM WITH FOUR ATTACHED TOILETS, BALCONIES & KITCHEN
    AII
    1584
    300
    27.72
    DRAWING/DINING, THREE BEDROOMS, ONE SERVANT ROOM WITH FOUR ATTACHED TOILETS, THREE BALCONIES & KITCHEN
    AIII
    1230
    265
    21.53
    DRAWING/DINING, THREE BEDROOMS, WITH TWO ATTACHED TOILETS, THREE BALCONIES & KITCHEN
    AIRMEN/SAILORS
    BI
    938
    480
    16.42
    DRAWING/DINING, TWO BEDROOMS, WITH TWO TOILETS, THREE BALCONIES & KITCHEN
    Instalment Schedule
    INSTALMENTS
    DUE DATE
    A-I
    A-II
    A-III
    B
    Registration
    30 Sep 06
    1.00
    1.00
    1.00
    0.50
    I
    05 Mar 07
    4.28
    3.30
    2.50
    1.50
    II
    08 May 07
    4.28
    3.30
    2.50
    1.50
    III
    05 Oct 07
    3.03
    2.38
    1.92
    1.50
    IV
    05 Jun 08
    3.03
    2.38
    1.92
    1.50
    V
    06 Oct 08
    3.03
    2.38
    1.92
    1.50
    VI
    08 May 09
    3.03
    2.38
    1.92
    1.50
    VII
    08 Sep 09
    3.03
    2.38
    1.92
    1.50
    VIII
    08 Apr 10
    3.03
    2.38
    1.92
    1.50
    IX
    3 Sep 10
    3.04
    2.42
    1.92
    1.54
    X
    7 Apr 11
    3.70
    3.42
    2.09
    2.38
    Interim
    29 Apr 13/
    02 Jul 13*
    5.00
    4.50
    4.00
    2.50
    For due amount please refer final call-up letter and Interim Installment.
    *Please refer Update dated 24 Jun 13 for details.
    Progress
    Foundation Stone laying ceremony as on 08 Mar 08
    Location Map
    Elevation View
    Layout view
    Plan Type: A-I
    Plan Type: A-II
    Plan Type: A-III
    Plan Type: B
    Inauguration



































    Prog. 14 Jun 14






















    28 Jul 14
